• IMPORTANT NOTICE

    * Allottees of Chennai OMR Project are advised to remit funds through NEFT/RTGS /NET Banking to ICICI Bank account of the Project.
    * Details are as follows :
    Name of Beneficiary : AWHO Chennai OMR Project
    Bank A/c No : 000701266853
    Bank Name : ICICI Bank
    Bank Address : 9A, Phelps Building, Connaught Place, New Delhi-110001
    IFS CODE : ICIC0000007
    Type of account : SB
    * After effecting remittance, members are requested to follow up with a mail to AWHO indicating the UTR No and Regn No for linking with individual account of member.

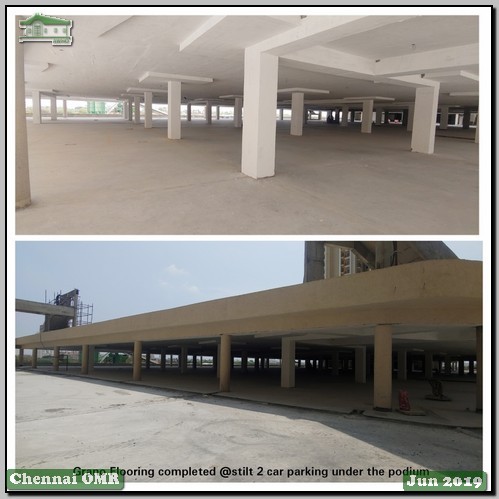

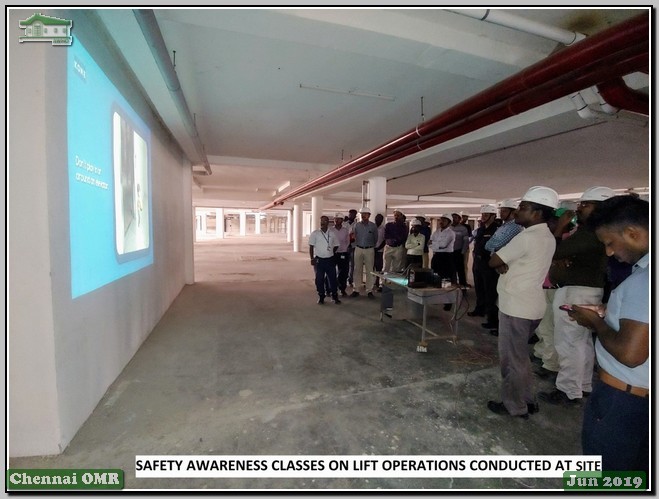

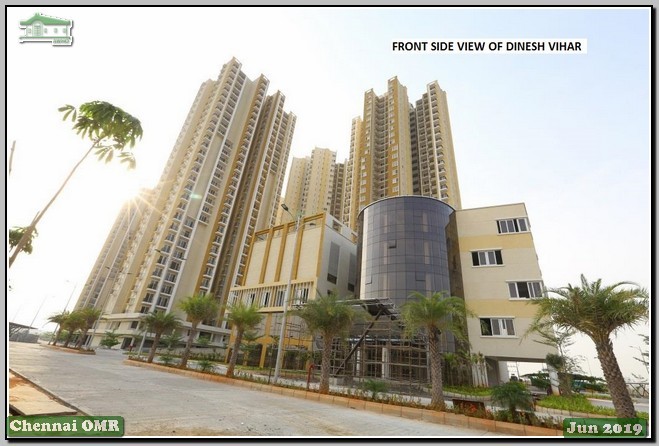

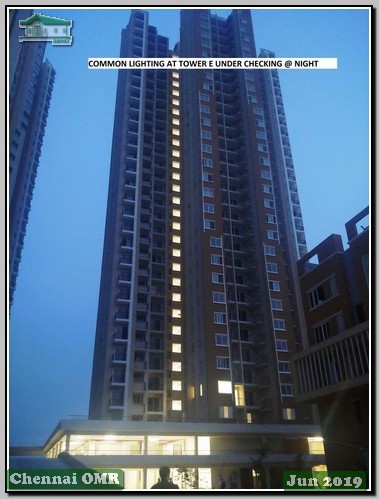

    Update : Project as on 17-06-19

    APPRECIATION FEEDBACK ON HANDING/TAKING OVER OF DUs AT OMR CHENNAI PROJECT

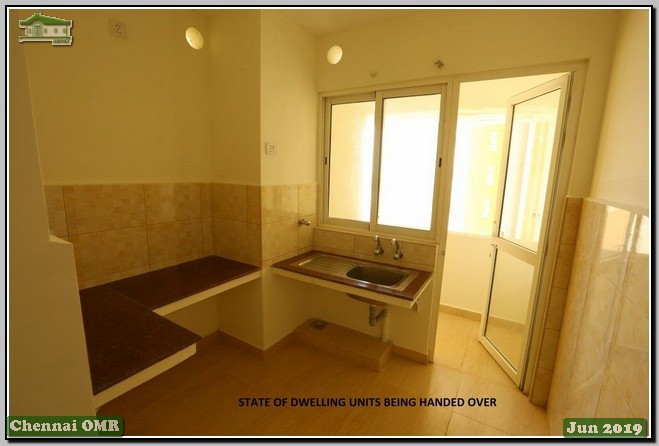

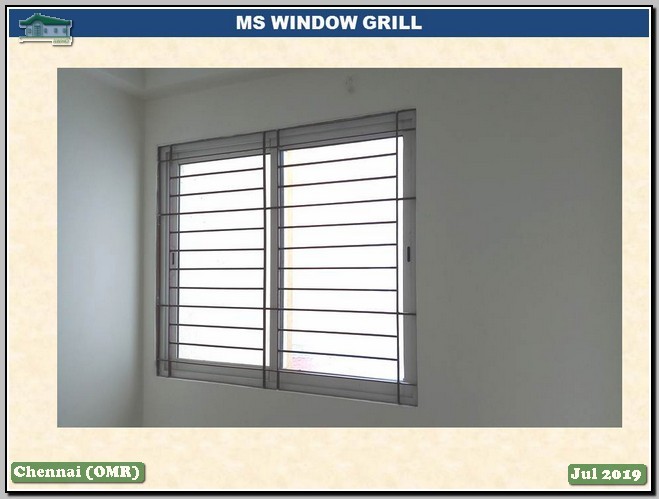

    Handing/taking over of DUs has commenced w.e.f. 22 Apr 2019. As on date, 45 DUs have been handed over. Appreciation/feedback received from some of the allottees during handing/taking over is attached for info of allottees.

    Update : Project as on 13-06-19

    STATUS ON VARIOUS ISSUES

    Update : Project as on 10-05-19

    PROVISION OF COMMUNICATION INFRASTRUCTURE

    1. Refer to the Notice on website dt 22 Mar 19 on the subject matter.
    2. Based on discussions with group of allottees at AWHO Chennai Site on 06 Apr 2019, it has been decided to permit the following Service Providers to establish their infrastructure at Dinesh Vihar at “No cost, No commitment’ basis:-
     (a) BSNL and their Channel Partner M/s Polestar
     (b) Airtel
     (c) Tatasky
     (d) ACT
     (e) Jio Gigafiber
    3. Allottees will have the option of choosing services of any of these Service Providers.

    Update : Project as on 11-04-19

    DO LETTER FROM MD AWHO TO THE ALLOTTEES OF OMR CHENNAI

    Update : Project as on 22-03-19

    PROVISION OF COMMUNICATION INFRASTRUCTURE IN AWHO, CHENNAI, OMR (DINESH VIHAR) PROJECT

    1. AWHO, Chenai OMR (Dinesh Vihar) project is nearing completion. Handing over of DUs of Tower ‘E’ and ‘F’ is likely to commence in Apr 2019.
    2. The allottees would require communication, internet and cable TV facilities immediately on occupation of their DUs. To facilitate provision of these facilities, which have to be paid for by the allottees, AWHO has explored various service providers and shortlisted them. The details are given below :-
    (a) Data and Voice Connectivity.
    (i) BSNL has proposed to provide state of the art FTTH (Fibre To The Home) at a reasonable tariff with a speed of 100 Mbps. Both voice and data connection is being given through the same Optical fibre cable. BSNL will provide free of cost laying of FTTH if they get minimum assured connection of 1/3rd population.
    (ii) ACT Fibre net is found to be most preferred agency in this region especially by the people who are working in IT sectors to provide DATA connectivity. They are ready to lay their fibre net free of cost with a speed of 150 Mbps. This can be provisioned in addition to BSNL service.
    (b) Cable TV.
    (i) Full High Definition (Full HD) as well as Standard Definition (SD) digital cable TV service shall be provided by M/s Pole Star Telecom private limited who is the Channel Partners of BSNL. They will provide cable TV and intercom service through the same Optical fibre cable laid for BSNL.
    (ii) M/s Sat Wave is also to provides Cable TV connection. They are specialist in Cable TV services from multiple agencies through the centralized antenna. This can be made available immediately in case of maximum allottees agree.
    3. Technical Brochure of (ACT FIBERNET, BSNL and POLE STAR TELECOM) firms except M/s Sat Wave are att herewith for perusal. Any other clarification required may be sought directly from the PD Chennai.
    4. Allottees are requested to fwd their feedback on our e-mail id This email address is being protected from spambots. You need JavaScript enabled to view it.. Based on willingness conveyed by the allottees, AWHO Chennai office can take proactive actions to have the communication and cable TV infrastructure in place by the time occupation of DUs commence.

    Update : Project as on 26-02-19

     DINESH VIHAR, OMR CHENNAI PROJECT

    1. Please refer “Update” uploaded on the AWHO Website on 11 Jan 2019.

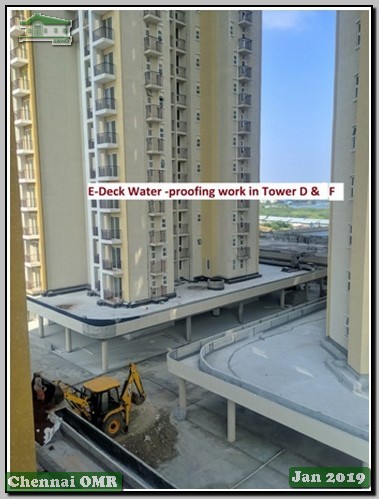

    2. TNEB has commenced work for provision of electrical infrastructure at the Project site. Fire pumps have also been received from M/s Kirloskar and are under installation. However, since mandatory clearances/NOC can only be obtained after installation of this equipment, the handing/taking over is being postponed. The handing over will commence in a phased manner for Towers E, F & D by 01 Apr 2019, which will be followed by handing/taking over of Towers A, B & C.

    Update : Project as on 11-01-19

     DINESH VIHAR, OMR CHENNAI PROJECT

    1. Please refer “Status on ‘Handing Over/Completion of the Project’ Issue” uploaded on the AWHO Website on 03 Dec 2018.

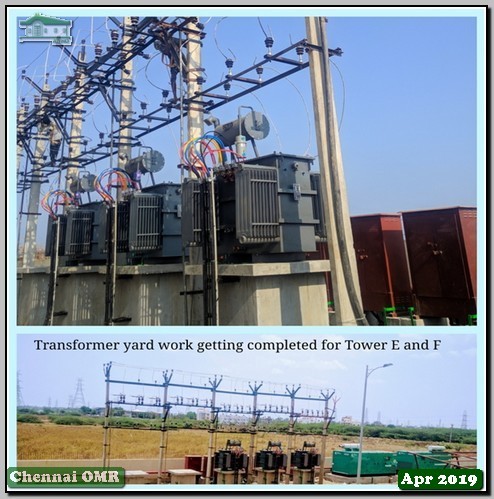

    2. Towers E & F are complete, and Tower D is also close to completion. However, due to delay in provision of electric infrastructure by TNEB, and delivery of fire pumps by M/s Kirloskar, Pune which in turn has delayed obtaining clearances/NOC from the concerned Departments, the handing/taking over has been postponed. Handing/taking over will now commence in a phased manner wef 15 Feb 19 for Towers E, F & D, which will be followed by handing/taking over of Towers A, B & C.

    Update : Progress as on 31-12-18

    Project Progress (Including Land Cost) : 89.70%
    Constr Progress : 87.00%

    Update : Project as on 24-12-18

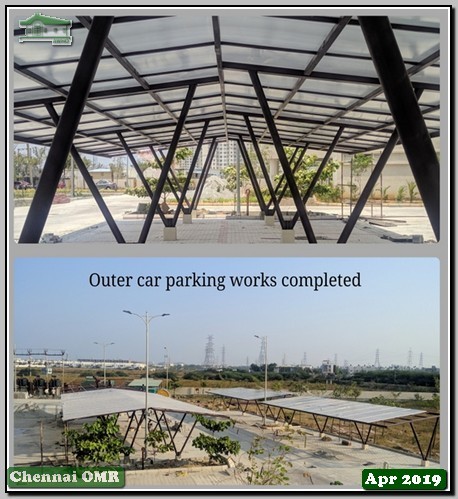

    A computerised draw for allotment of additional parking (OCPF) at OMR Chennai project was conducted by an independent Board of Officer detailed by AG’s Branch on 21 Dec 2018 at 1030h. Allottees who had opted for OCPF can view their draw results on AWHO website. Allotment letter will be fwd shortly.

    Update : Project as on 20-12-18

    A BOO detailed by AG’s Branch will conduct a Computerised draw on 21 Dec 18 at 1030h for allotment of addl Parking (OCPF) to the allottees of OMR Chennai.

    Update : Project as on 14-12-18

    UTILIZATION OF COMMON FACILITIES

    1.  Reference this office letter dt 26 May 2015.

    2.  All common facilities constructed in Phase-I have been charged to allottees of Phase-I only. Our letter mentioned above may please be treated as cancelled.

    Update : Project as on 03-12-18

    STATUS ON VARIOUS ISSUES OF DINESH VIHAR, OMR CHENNAI PROJECT

    Update : Progress as on 30-11-18

    Project Progress (Including Land Cost) : 88.91%
    Constr Progress : 86.00%

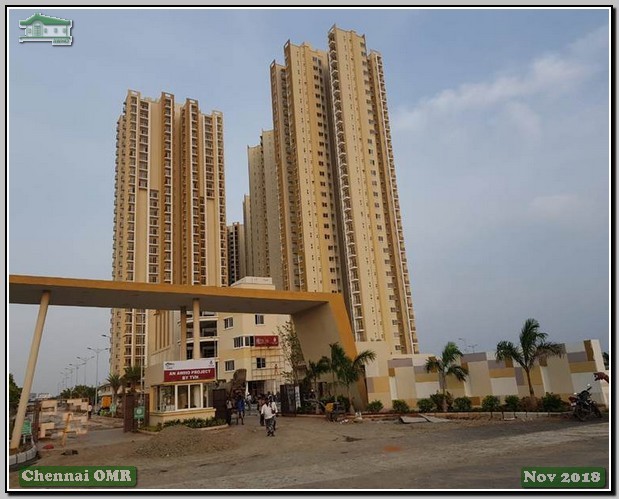

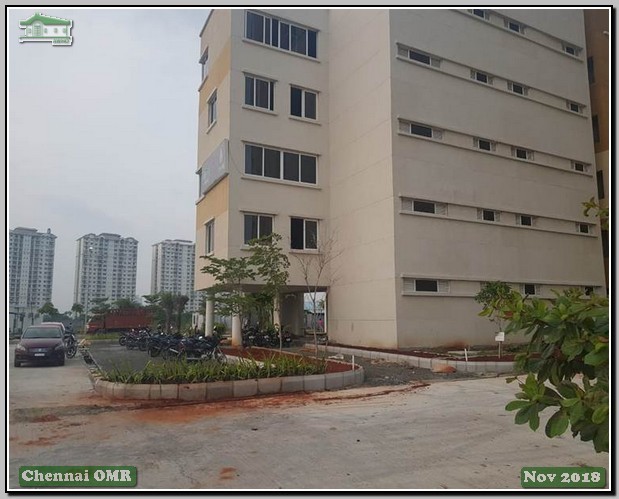

    Update : Project as on 08-11-18

    CHENNAI OMR : STAMP DUTY EXEMPTION

    Update : Progress as on 31-10-18

    Project Progress (Including Land Cost) : 88.12%
    Constr Progress : 85.00%

    Update : Project as on 31-10-18

     1. Please refer to Note 1 of our Allotment letter dated 22 Oct 18.

     2. The following amendments may please be made:-

     FOR. Allottees are welcome to visit the project office after prior intimation to see the progress and sample flat only. Contact numbers – 0422-266057, 3191007, 08827601666.

     READ. Allottees are welcome to contact Project office OMR Chennai at Contact No 044-29004431, 08886770332, 08650700016.

    Update : Progress as on 30-09-18

    Project Progress (Including Land Cost) : 86.53%
    Constr Progress : 83.00%

    Update : Dinesh Vihar (as on 23-10-18)

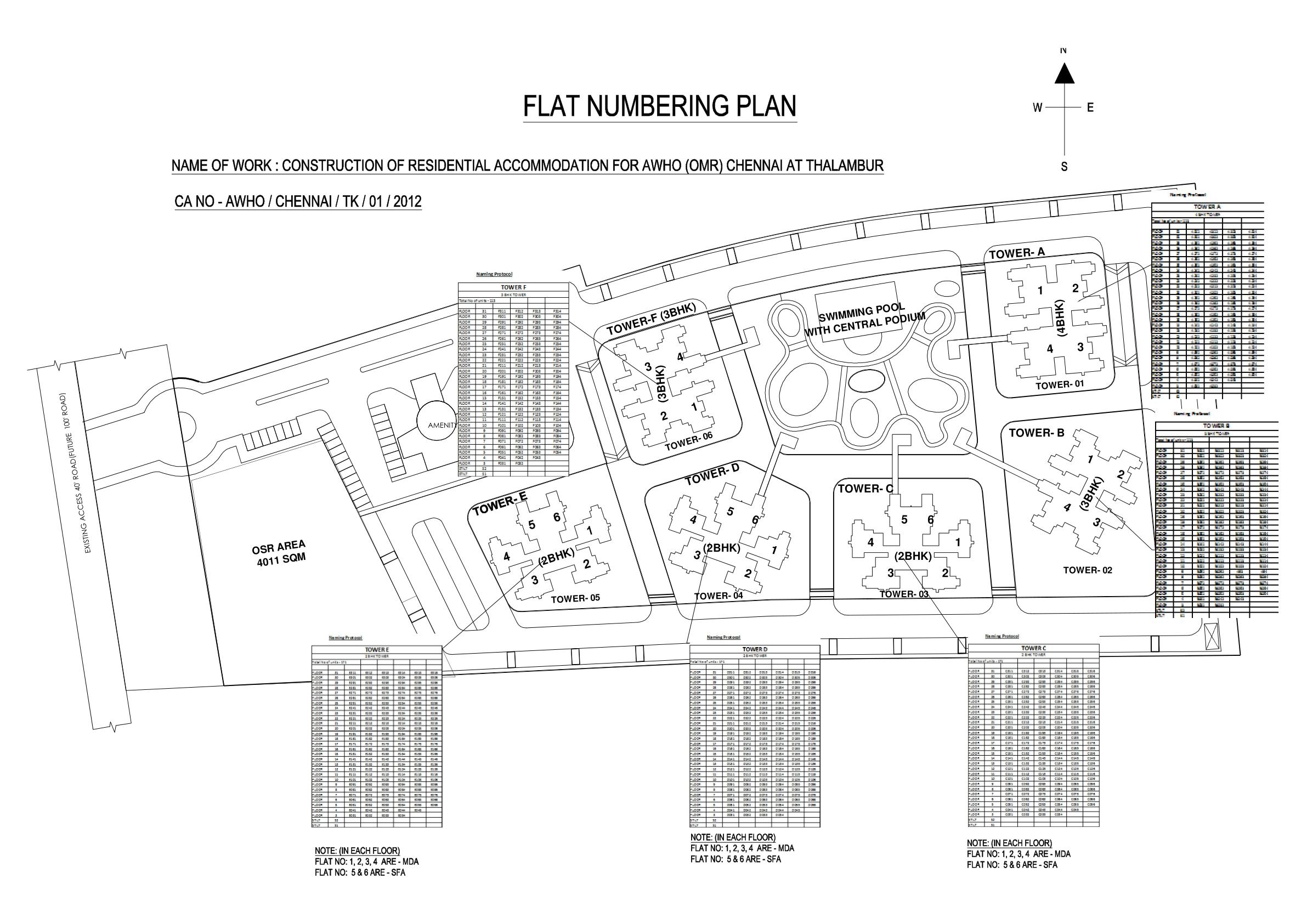

    Tower and Flat Numbering Plan

    Update : Dinesh Vihar (as on 17-10-18)

    Draw for specific DU / Floor & Car Parking spaces has been held on 16 Oct 2018. Result for the same has already been uploaded on AWHO Website.

    Update : Dinesh Vihar (as on 10-10-18)

    Progress of work is 83% (Constr Progress) & 86.53% (Project Progress) as on 30 Sep 2018.

    Update : Dinesh Vihar (as on 08-10-18)

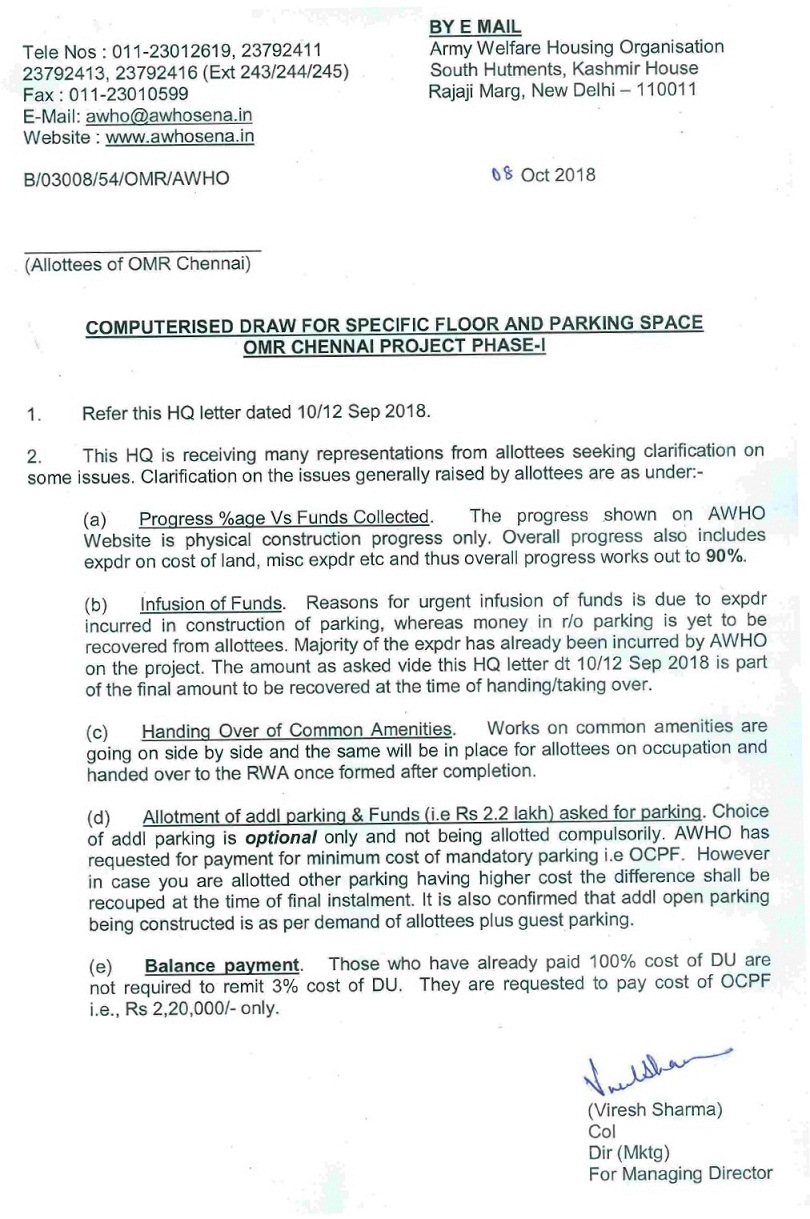

    COMPUTERISED DRAW FOR SPECIFIC FLOOR AND PARKING SPACE OMR CHENNAI PROJECT

    Update : Dinesh Vihar (as on 19-09-18)

    Progress of work is 81.5% as on 31 Aug 2018.

    Update : Dinesh Vihar (as on 02-08-18)

    Present progress is 81% as on 31 Jul 2018.

    Update : Dinesh Vihar (as on 05-07-18)

    Present progress is 79.84% as on 30 Jun 2018.

    Update : Dinesh Vihar (as on 01-05-18)

    OPTION LETTER FOR SPECIFIC FLOOR AND PARKING SPACE

    Update : Dinesh Vihar (as on 16-04-18)

    CHANGE OF PDC : OMR CHENNAI

    (a) In recent past a site review to ascertain the status of work in OMR Chennai was carried out. It is anticipated that PDC would be Sep 18. The revised schedule of PDC is due to value additions in the project.

    (b) Inconvenience caused is deeply regretted.

    Update : Dinesh Vihar (as on 06-04-18)

    Present progress is 77.4% as on 31 Mar 2018.

    Update : Dinesh Vihar (as on 12-03-18)

    Present progress is 77.2% as on 28 Feb 2018.

    Update : Dinesh Vihar (as on 10-02-18)

    Present progress is 77% as on 31 Jan 2018.

    Update : Dinesh Vihar (as on 06-12-17)

    Present progress is 75.5% as on 30 Nov 2017.

    Update : Dinesh Vihar (as on 20-11-17)

    Present progress is 74.6% as on 31 Oct 2017.

    Update : Dinesh Vihar (as on 20-10-17)

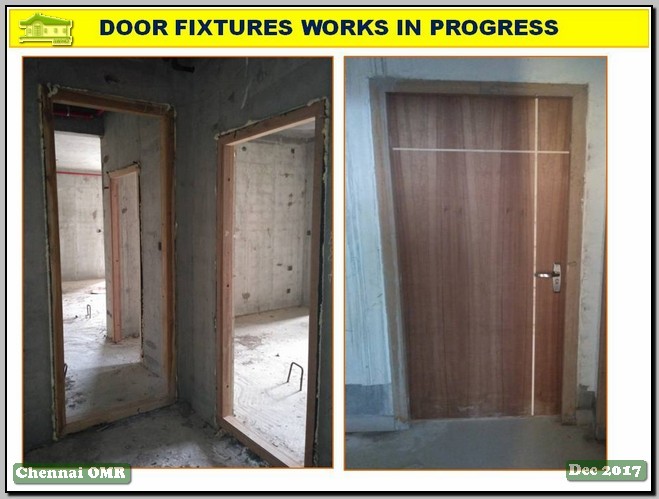

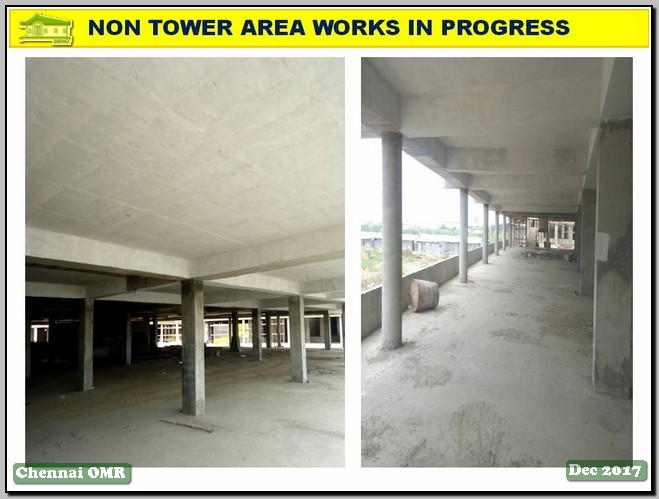

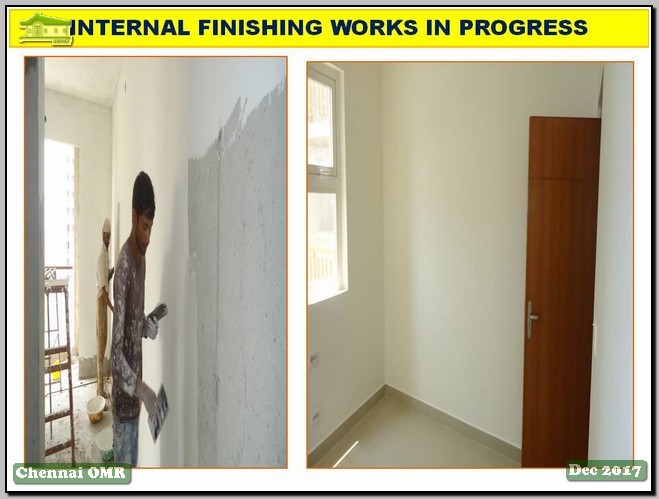

    BRIEF : DINESH VIHAR, OMR CHENNAI (TURNKEY PROJECT)

    PDC has been revised to APR 2018.

    Update : Dinesh Vihar (as on 05-09-17)

    Present progress is 73.6% as on 31 Aug 2017.

    Update : Dinesh Vihar (as on 03-08-17)

    Present progress is 72.3% as on 31 Jul 2017.

    Update : Dinesh Vihar (as on 11-07-17)

    Present progress is 72% as on 30 Jun 2017.

    Update : Dinesh Vihar (as on 16-06-17)

    Update : Dinesh Vihar (as on 13-06-17)

    Present progress is 71.35% as on 31 May 2017.

    Update : Dinesh Vihar (as on 28-04-17)

    IMPORTANT UPDATE

    Lorry / Tipper association in South India had called for an indefinite strike wef 30 Mar 2017, which was withdrawn on 09 Apr 2017. This has caused massive disruption in supply of building construction material for 11 days. After withdrawal notice the supplies are limping back to normal.
    Click here for more details.

    Update : Dinesh Vihar (as on 30-03-17)

    POSTPONEMENT OF PDC : OMR CHENNAI PH - I

    As on date the work has progressed to 68%. The work of main contract is going on as per schedule . All out efforts are being made to ensure progress as per schedule.

    However, the Probable Date of Competion (PDC) of the project is being revised to Dec 2017. The revision has been necessiated due to  ‘Vardha Cyclone’  which stalled construction for 2-3 months due to which a mismatch has occurred between the physical & planned progress.

    There is NO change in the amount of instalments and other terms and conditions.
    Inconvenience to the allottees is sincerely regretted please.

    Update : Dinesh Vihar (as on 02-03-17)

    Present progress is 68% as on 28 Feb 2017.

    Update : Dinesh Vihar (as on 08-02-17)

    Present progress is 67.1% as on 31 Jan 2017.

    Update : Dinesh Vihar (as on 03-01-17)

    Present progress is 67% as on 30 Dec 2016.

    Update : Dinesh Vihar (as on 30-11-16)

    Present progress is 66% as on 30 Nov 2016.

    Update : Dinesh Vihar (as on 11-11-16)

    Present progress is 65% as on 31 Oct 2016.

    Update : Dinesh Vihar (as on 24-10-16)

    REVISION OF PAYMENT SCHEDULE : OMR CHENNAI PROJECT

    Update : Dinesh Vihar (as on 04-10-16)

    Present progress is 64% as on 30 Sep 2016.

    Update : Dinesh Vihar (as on 15-09-16)

    Present progress is 62.3% as on 10 Sep 2016.

    Update : Dinesh Vihar (as on 18-08-16)

    Present progress is 60.7% as on 31 Jul 2016.

    Update : Dinesh Vihar (as on 08-07-16)

    CLARIFICATIONS ABOUT MISINFORMATION SPREAD ABOUT AWHO PROJECT AT CHENNAI

      REVISION OF PAYMENT SCHEDULE OMR CHENNAI PROJECT

    * Please refer to Para 40 of AWHO Master Brochure Jul 87 (as amended).

    * Due to unavoidable reasons, the physical progress is yet to match the planned progress.  All efforts are being made to speed up the work and complete the work by PDC  announced now.

    * In order to adhere to construction linked payment schedule, it has been decided to re-schedule the existing payment schedule of OMR Chennai Project as under :-

    (a) For Allottees with payment schedule As Under.
    First instalment - 25% cost of DU,
    Second to Fifth instalment - 15% cost of DU
    Sixth instalment - 10% cost of DU

    Ser

    No

    Type of Payment

    Instalment No

    Existing Due Date

    Revised Date of Payment

    (i)

    10% of Construction cost

    6th

    30 Aug 2016

     30 Nov2016

    (b) For Allottees with payment schedule As Under.
    First instalment - 35% cost of DU,
    Second - 20% cost of DU
    Third to Fourth Instalment- 15% cost of DU
    Fifth Instalment - 10% cost of DU

    Ser

    No

    Type of Payment

    Instalment No

    Existing Due Date

    Revised Date of Payment

    (i)

    10% of Construction cost

    5th

    30 Aug 2016

     30 Nov 2016

    (c) For Late Allottees with Payment Schedule As Under.
    First Instalment - 35% cost of DU
    Second to Third Instalment - 20% cost of DU

    Ser

    No

    Type of Payment

    Instalment No

    Existing Due Date

    Revised Date of Payment

    (i)

    20% of Construction cost

    4th

    30 Aug 2016
    16 Sep 2016
    27 Oct 2016

     30 Nov 2016

    * The above revised payment schedule be adhered to.
    * There is no change in the amount of instalment and other terms & conditions as given in the booking letter.
    * Revised PDC :- PDC has been revised from Dec 2016 to Jun 2017.

    LETTER TO ALL ALLOTTEES FOR PROPOSED VALUE ADDITIONS

    UTILISATION OF COMMON FACILITIES: OMR, CHENNAI PHASE I & II
    It is intimated that the common facilities of Club House (executed in the ongoing Phase-I) and Shopping Complex (planned in Phase-II) are for use by allottees of both phases I and II.

    AWHO PROJECT OMR CHENNAI

    Issues of provision of piped water supply of metro water and construction of approach road from DLF garden city to the project are being pursued with the TN State Government, and are being closely monitored.

    Value Additions being provided
    * Double stilt parking instead of basement + stilt planned earlier
    * Compound wall on pile foundation.

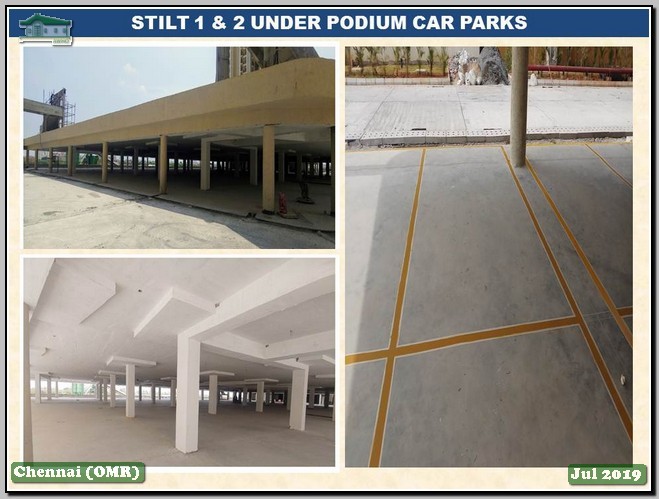

    * Additional common areas in stilt I & II
    * 2 BHK 141 Sq m
    * 3 BHK 47 Sq m
    * 4 BHK 81 Sq m
    * Granite flooring in corridors and staircase in lieu of green marble

    As a value addition piped LPG supply to all residential units is being planned.
    Case for exemption of stamp duty (6%) and registration charges (1%) has been taken up with TN State Government.

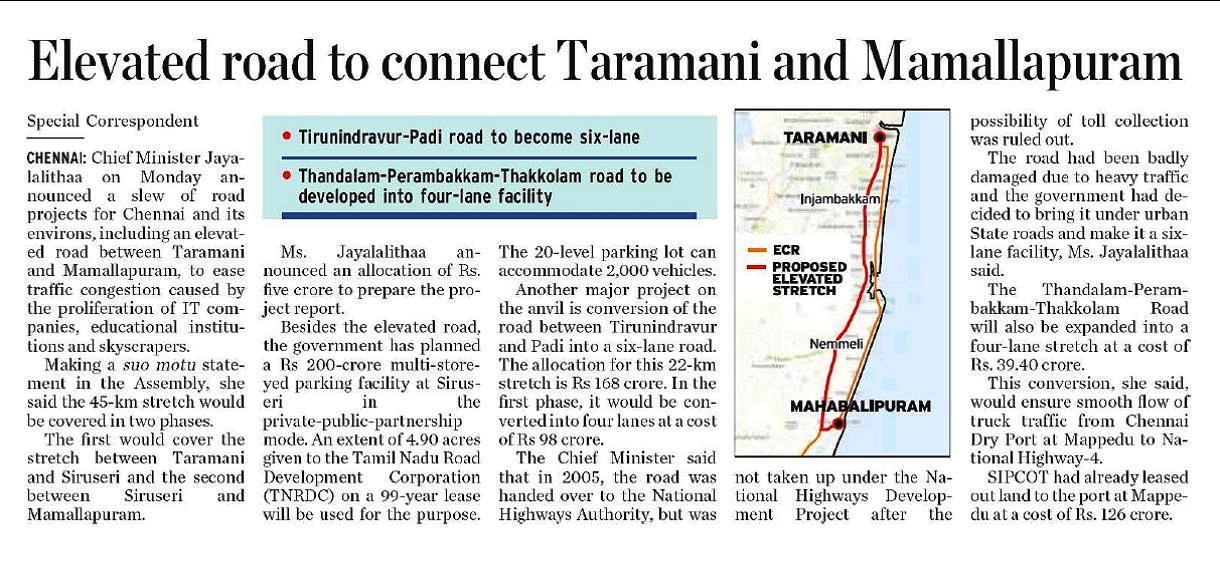

    ELEVATED ROAD TO CONNECT TARAMANI AND MAMALLAPURAM

    HOMES IN SUBURBS TURN COSTLIER AS CITY GROWS

    RENTALS IN CITY GO THROUGH THE ROOF

  •

    ANNUAL REGISTRATION OPEN

     Central Amenities

    All amenities and facilities including Club House, Swimming Pool, Sports Complex, Walking/Jogging, Plaza and Fitness Centre are part of Gated AWHO Colony.

    Following amenities are being provided in the towers
    * CCTV Cameras – At Block Entrances, club house entrance and main entrance.
    * Ledges In Dwelling Units for placing external units of air conditioners
    * Fibre to home for TV, telephone etc in each dwelling unit.
    * Garbage chutes at every floor.
    * Power backup
    * 1 KW FOR 4 & 3 BHK,
    * 0.5 K W FOR 2 BHK
    * Jogging, walking tracks & connecting  bridges to reach central podium
    * 2 x STP’s & Rainwater Harvesting pits

    Amenities at Podium
    * Swimming pool 25 m x 15 m
    * Children park
    * Fitness corner

    Outdoor Hard Courts for
    * Basketball
    * Volleyball
    * Badminton

    Amenities in Club house
    * Multipurpose hall
    * Conference rooms
    * Restaurant and bar
    * 3 x Guest rooms
    * Gym
    * Table tennis
    * Billiards room
    * Library
    * Squash courts

    Eligibility

    * Serving / Retired Army personnel and their widows who are in receipt of family pension and also parents of Unmarried Fatal Battle/ Other Casualties getting family pension are eligible to apply.
    * Those who already own a DU/Plot allotted by AWHO in other station may also apply. However they will be considered as Priority II. Waitlisted registrants of Annual / Spot schemes / registrants of various Demand Surveys of other stations are also eligible to apply.
    * Personnel of Assam Rifles, GREF, Air Force, Navy and their widows (in receipt of family pension) are eligible to apply.

    Probable Date of Completion

    SEP 2018

    Contact Details

    Project Director

     AWHO
    S No 172/1 & 173 (Near HLC School)
    Post Office : Thazhampur
    Tehsil : Chengalpattu
    District : Kancheepuram
    Chennai 600130

    AWHO CUSTOMER RELATIONSHIP
    MANAGEMENT CELL

    011-23012619, 23792411,
    23792413, 23792416
    FAX : 011-23010599
    E-MAIL ID : This email address is being protected from spambots. You need JavaScript enabled to view it.
