• IMPORTANT NOTICE

    * Allottees of Gurgaon Sector-95 Project are advised to remit funds through NEFT/RTGS /NET Banking to Syndicate Bank account of the Project.
    * Details are as follows :
    Name of Beneficiary : AWHO Gurgaon Sector-95 Project
    Bank A/c No : 91222160000119
    Bank Name : Syndicate Bank
    Bank Address : Kashmir House, Rajaji Marg, New Delhi-110011
    IFS CODE : SYNB0009122
    Type of account : SB
    * After effecting remittance, members are requested to follow up with a mail to AWHO indicating the UTR No and Regn No for linking with individual account of member.

    Update : As on 03-09-2020

    GURGAON SECTOR 95 (SHANTI VIHAR) blinking new small

    Update : As on 31-08-2020

    MINUTES OF MEETING WITH REPS OF SHANTI VIHAR, SECT-95 GURUGRAM AND OFFICIALS OF AWHO ON 10 AUG 2020 blinking new small

    Update : As on 18-08-2020

    VISIT OF ALLOTTEES TO TOWERS C, D, L, Q & R : AWHO SEC-95, GURGAON

    Further to web update dt 07 Jul 2020. Allottees of towers C, D, L, Q & R, who have paid their final amount as per FSA and desirous of taking over their DUs in Oct – Nov 2020 may visit the DUs (after tying up suitable date and time with the Project Director Col Karunesh Kumar (Retd) at Mobile No 9717770341 or Rxn Cell Mob Nos 8447430314 & 9891592251) and notify their observations, if any. Same shall be recorded by the PD in register meant for this purpose and rectified before 01 Oct 2020 so that when allottees reach the site to take over their DU post 01Oct 2020, they get a ready DU without any observations or shortcomings. This shall facilitate smooth handing / taking over.

    Update : As on 31-07-2020

    SHIFTING OF 220 KVA HT LINE AWHO PROJ GURGAON SEC-95

    1. Based on representation by a few allottees, a case was taken up with Bhakra Beas Management Board (BBMB), the owner of the line to see the feasibility of either making it underground or sifting the same.
    2. BBMB vide their letter No 2621/ 24 /EST-1113 dt 27 Jul 2020 (copy enclosed) have replied the following :-
         (a)     No line has been made underground for a private agency.
         (b)     However, in case the competent authority permits the same, in addition to the requirement of addl land on either end of the line, it would require an NOC from GMDA, HUDA and HVPNL.
         (c)     Also the complete cost of shifting/ making underground shall have to be borne by AWHO which will further be borne by the allottees. This shall be a substantial amount.
    3. In view of the above, the shifting / making underground the 220 KVA line is considered not feasible at this stage.

    Update : As on 07-07-2020

    RESCHEDULE OF COMMENCEMENT OF HANDING OVER AND LAST DATE OF PAYMENT

    1. Further to our ‘Update’ dt 05 Jun 2020 as regards the commencement of handing over of DUs in AWHO Sector-95, Gurgaon. The obtaining of ‘Occupation Certificate ‘ (OC) is likely to be further delayed due to the lockdown and related issues of COVID – 19, leading to delay in site visit by the concerned state govt officials. Accordingly, the commencement of handing over of DUs of the first lot of towers ie, Towers C,D,L,Q & R is postponed till 30 Sep 2020 with the last date of payment as 15 Oct 2020. All out efforts will be made to commence handing over prior to 30 Sep 2020 and allottees will be intimated in advance should the situation improve. The schedule of handing over of DUs of balance towers shall be announced once the actual handing over commences.

    2. Allottees wishing to take over their DU shall have to make full payment and obtain clearance from AWHO prior to taking over. The handing over schedule shall be reviewed in the first week of Sep 2020, based on situation prevailing at that time.

    Update : As on 05-06-2020

    POSTPONEMENT OF HANDING/TAKING OVER SCHEDULE AND LAST DATE OF PAYMENT

    The commencement of Handing/Taking Over Schedule in r/o AWHO Sector – 95, Gurgaon is presently postponed till 15 Jul 2020. This is due to existing lockdown restrictions which has affected the availability of labour at site as also the process of obtaining the Occupation Certificate. Accordingly, the exact handing over schedule for the first lot of towers ie Towers C, D, L, Q & R shall be announced after the `Occupation Certificate’ has been obtained and sufficient labour is available for the final finishing prior to handing over. Presently the last date of payment in r/o Towers C, D, L, Q & R is also postponed to 30 Jul 2020.

    Update : As on 07-04-2020

    RE-SCHEDULE OF LAST DATE OF PAYMENT IN R/O AWHO PROJECT GURUGRAM SECT 95

    Due to COVID-19 outbreak and subsequent nationwide lockdown, the last date of payment for allottees of Tower ‘C’, ‘D’, ‘L’, ‘Q’ & ‘R’, of AWHO Project Gurugram Sect 95 has been postponed to 30 Jun 2020. Dates for commencement of handing/taking over will be intimated later. Handing/taking for Tower ‘C’, ‘D’, ‘L’, ‘Q’ & ‘R’ will commence wef 15 Jun 2020. This shall be further reviewed in last week of May 2020 based on situation prevailing at that time.

    Update : As on 25-03-2020

    Due to the COVID-19 outbreak and subsequent nationwide lock down the last date of payment for Gurgaon 95 has been postponed as under :-

    S.NO. LAST DATE OF PAYMENT POSTPONED TO
    1 23 Mar 2020 &
    20 Apr 2020
    25 APR 2020

    Update : As on 23-03-2020

    HANDING/TAKING OVER SCHEDULE

    Handing/Taking Over Schedule of AWHO Sector – 95, Gurgaon is presently postponed by a month due to the effect of COVID-19 Virus, leading to delay in obtaining Occupation Certificate (OC), due to restricted functioning of the State Government. The fresh schedule shall be communicated subsequently, depending on the ground situation.

    Update : As on 18-02-2020

    ARBITRATION / COURT CASES UPDATE/PROGRESS

    Contract concluded with M/S Ramprastha Promoters & Developers Pvt Ltd. was cancelled due to default of contractor and contract to get the balance work completed through other agency at Risk & Cost of Contractor has been concluded and in progress. AWHO invoked the arbitration. Arbitral proceedings are in progress. Any amount received by AWHO through decree of court after exhausting all legal remedies by both the parties, shall be credited to Project Account.

    Update : As on 07-02-2020

    MINUTES OF MEETING HELD ON 31 JAN 2020 AWHO SECTOR-95 GURGAON

    Update : As on 27-01-2020

    HANDING / TAKING OVER INSTRUCTIONS AND STATEMENT OF ACCOUNTs

    Update : As on 14-01-2020

    SITE VISIT BY ALLOTTEES

    Update : Progress as on 31-12-19

    Project Progress (Including Land Cost) : 96.06%
    Constr Progress : 93.15%

    Update : As on 19-12-19

    GURGAON SEC-95 : H/O OF DUs

    Construction on the project has recommenced after lifting of ban by the Hon’ble Supreme Court on 10 Dec 2019, which remained suspended from 26 Oct 2019 to 09 Dec 2019. Accordingly it is proposed to commence the handing over of DUs from the third/ fourth week of Mar 2020. The final statement of account shall be sent to the allottees as per towerwise schedule of handing over from Jan 2020 onwards.

    Update : As on 18-12-19

    DRAW FOR ALLOTMENT OF ADDL PARKING G-95 PROJECT

    1. Draw for additional parking at Gurgaon Sector-95 project will be held on 10 Jan 2020 at 1100 hrs onwards at HQ AWHO by an internal Board of Offrs. Additional parking once allotted in the above draw will not be cancelled in any circumstances. Hence, allottees who have given their option for additional parking are requested to re -consider their willingness for the same if they so desire latest by 31 Dec 2019. No repeat NO representation will be accepted thereafter.
    2. Please NOTE that after allotment no request for cancellation of additional parking will be entertained.
    3. Allottees desirous of attending the draw may do so under their own arrangements. The draw will be held on 10-Jan-2020 at 11:00hrs onwards.

    Update : As on 20-11-19

    GURGAON SEC-95 : LATEST UPDATE

    Due to enhanced pollution in the NCR region, the Hon’ble Supreme Court has banned all construction activities including operation of DG Sets wef 01 Nov 2019 till further orders.

    Update : As on 05-11-19

    GURGAON SEC-95 : VISITING HOURS

    In order to avoid mishaps and interference in constr activities, all allottees/ visitors are requested to visit the site only on Saturdays and Sundays as per the following timings :-
     (a) Morning - 10.00 AM to 12.00 PM.
     (b) Evening - 02.00 PM to 04.00 PM.

    Update : Progress as on 31-10-19

    Project Progress (Including Land Cost) : 95.68%
    Constr Progress : 92.50%

    Update : As on 29-10-19

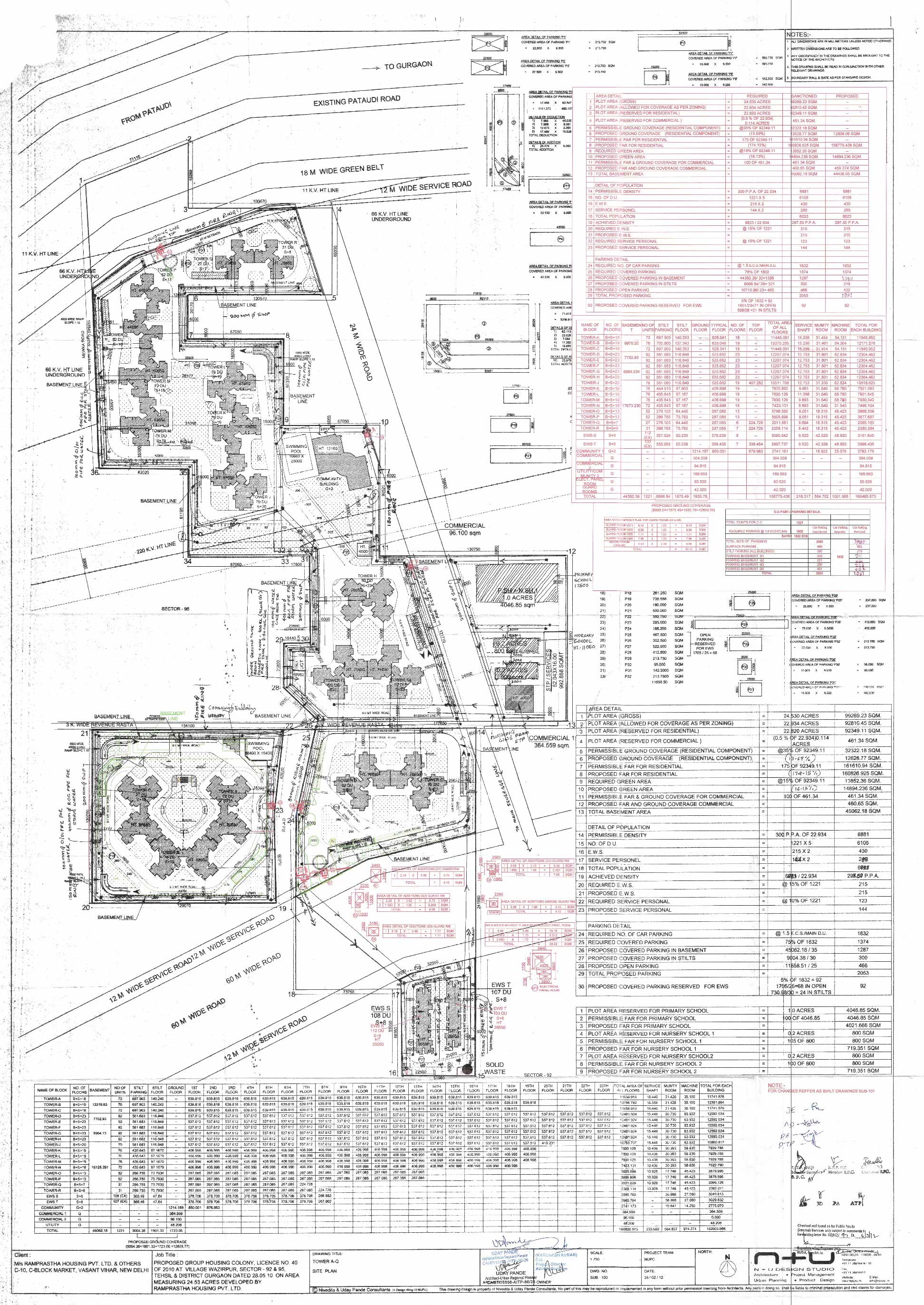

    DU NUMBERING AND PARKING PLANS

    ALLOTMENT MASTER PLAN - (TOWER A TO R)

    DU NUMBERING PLANS

    TOWER A TO C

    TOWER D TO E

    TOWER F TO H

    TOWER J TO R

    BASEMENT CAR PARKING PLANS

    TOWER A TO C

    TOWER D TO E

    TOWER F TO H

    TOWER J TO R

    STILT CAR PARKING PLANS

    TOWER A TO C

    TOWER D TO H

    TOWER J TO R

    OPEN CAR PARKING PLANS

    TOWER A TO C

    TOWER D TO E

    TOWER F TO H

    TOWER J TO R

    Update : Progress as on 30-09-19

    Project Progress (Including Land Cost) : 94.82%
    Constr Progress : 91.00%

    Update : As on 11-09-19

    GURGAON SEC-95 : VISITING HOURS

    All allottees wishing to visit the project are requested to do so between 1000 hr and 1700 hr on all days (including Sunday). This is to avoid any mishap during the hours when adequate staff in not present at site.

    Update : As on 03-09-19

    SITE VISIT ON 31 AUG 2019

    1. A site visit by allottees was conducted on 31 Aug 2019. Approx 28 allottees alongwith Lt Gen Narendra Singh (Retd) were present for the visit. The allottees also included two members of the PMG.
    2. The allottees were briefed by Lt Gen Narendra Singh (Retd) as regards his meeting with the COAS where Sub Maj (Hony Lt) LS Chauhan was also present. The main issues discussed were timely completion of the project by Dec 2019 and maintenance of quality.
    3. Thereafter the allottees were conducted on site to see the latest progress. A briefing on the issues raised by various allottees from time to time was also given by the Project Director, where it was confirmed that AWHO is making all efforts to complete the project by end Dec 2019.
    4. The progress at the site was appreciated by the allottees.

    Update : Progress as on 31-08-19

    Project Progress (Including Land Cost) : 94.24%
    Constr Progress : 90.00%

    Update : As on 26-08-19

    OPTION LETTER FOR SPECIFIC FLOOR AND PARKING SPACE

    Update : Progress as on 31-07-19

    Project Progress (Including Land Cost) : 93.26%
    Constr Progress : 88.30%

    Update : As on 08-07-19

    OPENING OF REGISTRATION FOR PARA MILITARY PERSONNEL

    LATEST UPDATE

    1. Col AK Rawal along with following visited the site on 05 Jul 19 from 1500 to 1700hrs :-
    (a) Col Shashikant G Dalvi (Retd), National Coordinator (Water Conservation).
    (b) Mr Raj Mohan, Founder Sustainable Green Initiative.
    (c) Mr HK Singh.
    2. Project Director briefed them about the rain water harvesting, sewage treatment plant & plantation of project in detail followed by site visit to include constr of pits & sump.
    3. Col Dalvi & Mr Raj Mohan appreciated the planning and execution of work. Col Dalvi complimented to that extent that he had not seen such a good rain water harvesting in the past.

    Update : Progress as on 30-06-19

    Project Progress (Including Land Cost) : 92.51%
    Constr Progress : 87.00%

    Update : As on 26-06-19

    SITE VISIT BY ALLOTTEES ON 22 JUN 2019

    Update : As on 24-06-19

    MD’s LETTER TO ALL ALLOTTEES DATED 17 JUN 2019

    Update : As on 05-06-19

    Photographs for Jun month has been uploaded.

    Update : As on 14-05-19

    LATEST UPDATE : AWHO SEC-95, GURGAON

    1. A number of allottees have queried on the construction of schools as part of AWHO Sector-95, Gurgaon project and the confirmation of payment for the same due on 31 May 2019.
    2. AWHO’s efforts to sell the partially constructed schools has not proved to be successful, and hence these need to be constructed out of project funds in order to obtain project completion.  Thus, it is confirmed that the installment due on 31 May 2019 towards ‘School Construction and Enhanced Power Back Up’ is required to be paid by all allottees.

    Update : Progress as on 31-05-19

    Project Progress (Including Land Cost) : 91.08%
    Constr Progress : 84.50%

    Update : As on 02-04-19

    INTERACTION WITH ALLOTTEES ON 30 MAR 2019

    Update : Progress as on 31-03-19

    Project Progress (Including Land Cost) : 89.81%
    Constr Progress : 82.30%

    Update : As on 07-03-19

    Dismantling of the Chemical Factory has commenced

    Update : Progress as on 28-02-19

    Project Progress (Including Land Cost) : 87.62%
    Constr Progress : 78.50%

    Update : As on 15-02-19

    CLOSURE OF CHEMICAL FACTORY

    1. Due to sustained efforts by AWHO with the "State Pollution Control Board" the owner of the chemical factory adjacent to AWHO Sector–95, Gurgaon has been asked to shut down and subsequently shift the factory.

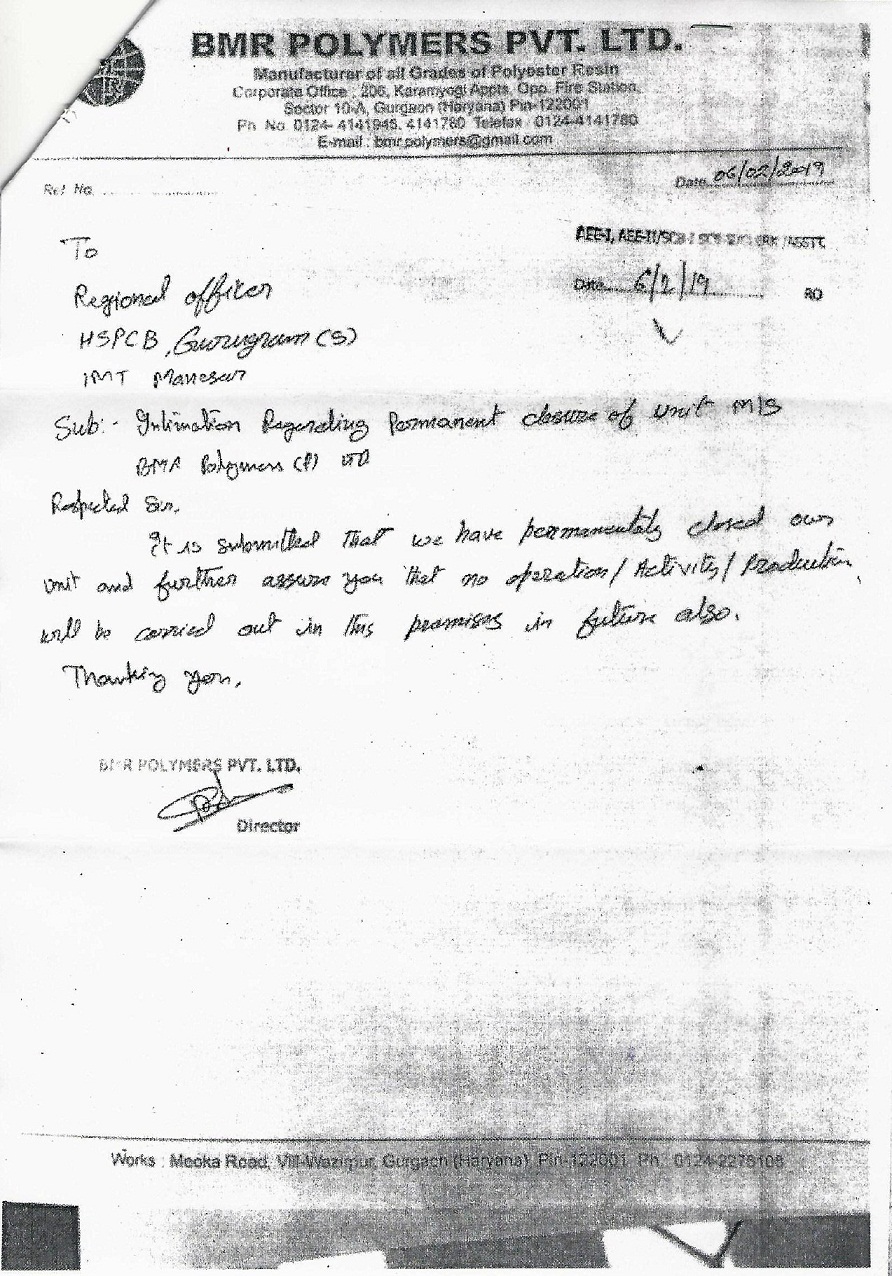

    2. A copy of the letter to this effect from the owner of the factory addressed to the Regional Officer, State Pollution Control Board is enclosed here.

    Update : As on 06-02-19

    GURGAON SEC-95 : CLARIFICATION ON SALE OF SCHOOL

    Update : Progress as on 31-01-19

    Project Progress (Including Land Cost) : 86.76%
    Constr Progress : 77.00%

    Update : As on 31-01-19

    SALE OF 1.60 ACRES OF LAND ALONG WITH PARTIALLY CONSTRUCTED SCHOOLS INSIDE AWHO PROJECT AT SECTOR – 95 GURUGRAM, HARYANA

    Update : As on 10-01-19

    OPENING OF REGISTRATION FOR ASSAM RIFLES, GREF, AIR FORCE, NAVAL AND INDIAN COAST GUARD (ICG)

    Update : Progress as on 31-12-18

    Project Progress (Including Land Cost) : 85.89%
    Constr Progress : 75.50%

    Update : As on 13-12-18

    FEEDBACK ON QUALITY RELATED ISSUES RAISED BY CERTAIN ALLOTTEES

    Update : Progress as on 30-11-18

    Project Progress (Including Land Cost) : 84.63%
    Constr Progress : 73.10%

    Update : As on 15-11-18

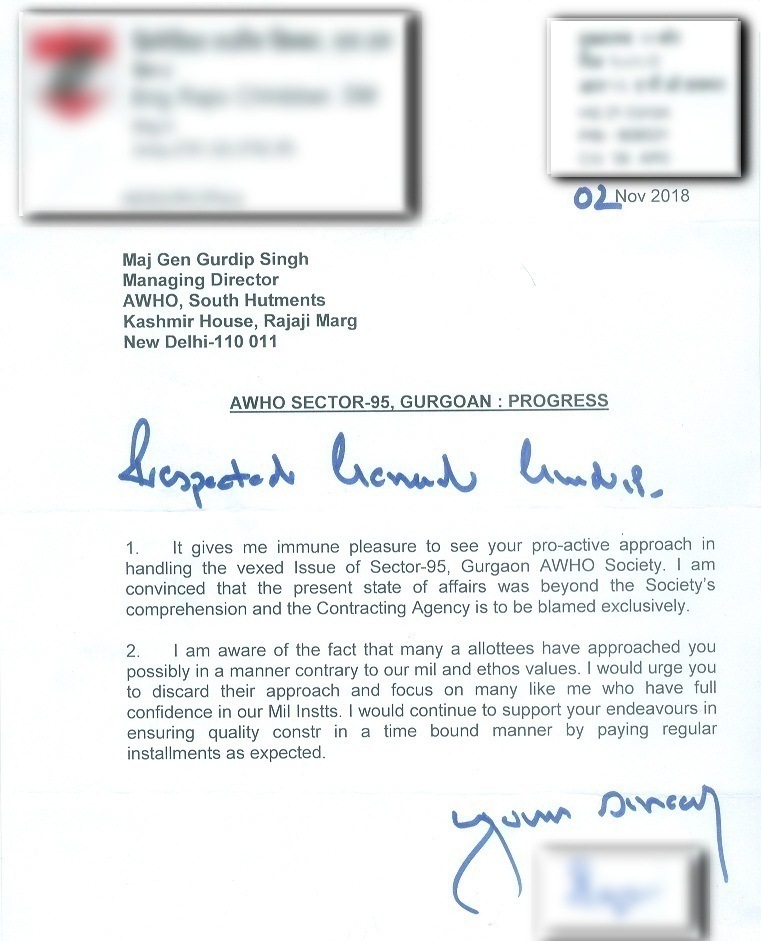

    DO LETTER FROM AN ALLOTTEE OF G-95 PROJECT

    Update : Progress as on 31-10-18

    Project Progress (Including Land Cost) : 83.94%
    Constr Progress : 72.10%

    Update : As on 25-10-18

    Update of Individual Running Ledger Account (IRLA)

    (a) Immediately after transferring amount through bank, allottees are required to intimate Registration No,  UTR/NEFT No with  Date of Transaction and amount details by e-mail to AWHO.
    (b) Members are requested to wait for a minimum period of 15 days before raising any queries on updation of account/non-issue of receipt.

    Update : Progress as on 30-09-18

    Project Progress (Including Land Cost) : 82.67%
    Constr Progress : 70.00%

    Update : Shanti Vihar (as on 16-10-18)

    GURGAON SEC-95 : LETTER FROM MD, AWHO

    Update : Shanti Vihar (as on 04-10-18)

    GURGAON SEC-95 : LETTER FROM MD, AWHO

    Update : Shanti Vihar (as on 04-09-18)

    GURGAON, SECTOR-95 : LATEST UPDATE

    Update : Shanti Vihar (as on 23-08-18)

    GURGAON SEC-95 : LATEST UPDATE

    1. The new contractor M/S Baba Construction Pvt Ltd were given the work order and handed over the site on 11 Aug 2018.
    2. Work has commenced by holding a `Havan’ at site followed by tree plantation on 15 Aug 2018.

    GURGAON SEC-95 : ALLOTTEES INFORMATION UPDATE

    Update : Shanti Vihar (as on 16-08-18)

    OPENING OF SPOT SCHEME FOR AWHO HOUSING PROJECT GURGAON, SECTOR-95 FROM 16 AUG 2018 TO 14 SEP 2018

    Update : Shanti Vihar (as on 14-08-18)

    EVENT : CELEBRATION OF INDEPENDENCE DAY AND MAKE AN AUSPICIOUS BEGINNING FR RE-COMMENCING THE BALANCE WORKS

    Update : Shanti Vihar (as on 07-08-18)

    GURGAON SEC-95 : REVISED PAYMENT SCHEDULE

    Update : Shanti Vihar (as on 28-05-18)

    GURGAON, SECTOR - 95 PROJECT : LATEST UPDATE

    Update : Shanti Vihar (as on 17-05-18)

    GURGAON, SECTOR - 95 PROJECT : LATEST UPDATE

    Update : Shanti Vihar (as on 09-02-18)

    GURGAON, SECTOR - 95 PROJECT : LATEST UPDATE

    Update : Shanti Vihar (as on 19-01-18)

    LATEST UPDATE : SECTOR-95, GURGAON

    1. Consequent to the cancellation of contract with M/s Ramprastha Promoter & Developers Pvt Ltd (RPDL) on 05 Jan 2018, action to re-commence construction as per the timelines given below has been initiated :-

    Assembling of BOOs at site for finalization of inventories 16 Jan 2018
    Submission of Board Proceedings with inventories of completed and incomplete work 16 Feb 2018
    Notice for Issue of Tender (NIT) 29 Jan 2018
    Completion of tendering process 30 Jun 2018
    Re-commencement of work 01 Jul 2018
    Completion of work 30 Sep 2019

    2. It is assured that AWHO is taking all necessary steps/ actions which are in the best interest of the allottees to ensure early completion of work with high standard of execution.

    Update : Shanti Vihar (as on 05-01-18)

    * RERA Registration of the project has been completed.
    * The contract of M/s Ramprastha Promoter & Developers Pvt Ltd has been cancelled on 05 Jan 18.
    * The sequence of actions for restarting the work has been initiated. Early commencement of construction is envisaged. Further updates will be given soon.

    Update : Shanti Vihar (as on 14-11-17)

    LATEST UPDATE ON AWHO PROJECT AT SECTOR-95, GURGAON

    Update : Shanti Vihar (as on 25-09-17)

    LATEST UPDATE : SECTOR-95, GURGAON

    A meeting was held as per schedule between the Executive Committee of AWHO and the apex management team of M/s Ramprastha Promoters & Developers Pvt Ltd on 19 Sep 2017.  The contractor underlined his commitment to complete the project regardless of cost.  A fund infusion plan of Rs 25 Crore in three transactions starting 31 Oct onward till 15 Dec 2017 was formalized targeting completion within twelve months.

    Update : Shanti Vihar (as on 05-09-17)

    UPDATE AWHO PROJECT SECTOR-95 : GURGAON

    * The concerns regarding slow progress of work at the site were discussed by the higher management during the 134th Executive Committee Meeting of AWHO held on 23 Aug 17.
    * After detailed deliberation on the options available it was decided to summon the Apex Management of M/s Ramprastha Promoters & Development Private Limited for way ahead.
    * The meeting is scheduled in third week of Sep 17 and further updates will be provided.

    Update : Shanti Vihar (as on 17-08-17)

    LATEST UPDATE : SECTOR-95, GURGAON

    1. A meeting was held between representatives of the allottees and MD, AWHO at HQ AWHO on 16 Aug 2017.
    2. Progress of the project was discussed alongwith reasons for the delay. It was apprised that AWHO is making all out efforts to complete the project which was well appreciated.
    3. Final decision on the Contract management will be taken in a meeting of the Higher Management scheduled in last week of August. Allottees would be informed accordingly.

    Update : Shanti Vihar (as on 21-07-17)

    AWHO PROJECT AT SECTOR – 95 GURGAON

    1. The rate of progress at site has been under intense scrutiny by HQ AWHO. Several measures have been implemented to accelerate the pace of work.
    2. In continuation of the efforts to achieve early completion, a series of meetings with the higher management of M/s Ramprastha Promoters and Developers Pvt Ltd and MD AWHO were held on 18 Apr, 24 Apr, 02 May and 12 May 2017. As an outcome, the following was achieved :-
    (a) A contractual obligation to complete the project by 30 Apr 18 has been signed.
    (b) M/s Ramprastha Promoters and Developers Pvt Ltd has been insisted upon to give a time bound schedule for infusion of funds in the project.
    3. Further measures to protect the interest of allottees are being contemplated.

    Update : Shanti Vihar (as on 16-04-17)

    Update : Shanti Vihar (as on 19-04-17)

    Progress of work is 68% as on 31 Mar 2017.

    Update : Shanti Vihar (as on 28-02-17)

    ENHANCEMENT OF BACKUP POWER SUPPLY

    1. A communication to allottees of Gurgaon Sector-95 inviting their views on enhancing the backup power supply to 5 KW for LXA/SDA/DXA and 3 KW for SFA against the present provision of 1.2 KW was sent by email, and the same was also uploaded on Website.
    2. A total of 320 responses were received of which 265 allottees have expressed willingness. As per the intimation, Nil response is being considered as willingness for the additional power back up. Hence , the majority view is for provision of additional power back up.
    3. Keeping in mind the majority view as well as the ‘valued addition’ this provision gives to the property and also since the allottees have already been informed that majority view would be implemented, provision of additional back power supply is being executed. The exact cost would be `intimated at the time of final costing.

    Update : Shanti Vihar (as on 07-02-17)

    Progress of work is 66.5% as on 31 Jan 2017.



    Update : Shanti Vihar (as on 03-01-17)

    Progress of work is 65% as on 31 Dec 2016.



    Update : Shanti Vihar (as on 06-12-16)

    ENHANCEMENT OF BACKUP POWER SUPPLY

    Keeping in mind the ongoing difficulties that our allottees are facing due to existing banking scenario, it has been decided to further extend the due date for payment of 6th/5th/4th/3rd (as applicable) installment from 16 Dec 2016 to 16 Jan 2017. Rest NO change.



    Update : Shanti Vihar (as on 02-12-16)

    Progress of work is 63% as on 30 Nov 2016.

    In view of the present bank scenario, due to demonetization of currency and numerous requests received from allottees, the due date for payment of 6th/5th/4th/3rd (as applicable) installment for Gurgaon, Sector-95 Project has been extended from 30 Nov 2016 to 16 Dec 2016. Rest NO change.



    Important Update

    Due to  concerted pressure on the Contractor to speed up the work, an agreement to infuse additional funds into the project has been arrived at.  An Escrow Account has now been opened between the builder, M/s Ramprastha  Promoters     & Developers Pvt Ltd and AWHO to ensure application for the work only.  This will help in flow of funds and  consequently speeding up  of the work,  with adequate  accountability attached.



    Update : Shanti Vihar (as on 07-11-16)

    Physical progress is approx 62% as on 31 Oct 2016.



    Update : Shanti Vihar (as on 13-10-16)

    GURGAON SECTOR-95 : IMPORTANT UPDATE

    Update : Shanti Vihar (as on 12-09-16)

    Physical progress is approx 60.27% as on 31 Aug 2016.

    REGISTRATION CLOSED w.e.f. 24 AUG 2016
    However, registration for widow quota is still open
    for eligible widows only.



    Update : Shanti Vihar (as on 08-08-16)

    Physical progress is approx 60% as on 31 Jul 2016.

    Update : Shanti Vihar (as on 08-07-16)

     UPDATE :  GURGAON SECTOR - 95

    Due to inadequate resources infusion   by the Contractor, the progress at site is slow.  However, continuous efforts are on to expedite the progress.  Meetings with top management have been held three times in last four months and also fortnightly review  meetings are being held with at  site to ensure increased speed of work.  Due to these efforts, working strength, which was around 300 till the months of Feb/  Mar, has increased to  600 plus  in the last  month.   Pressure is on to increase resources further.  The allottees will be kept updated.

    Physical progress is approx 59% as on 30 Jun 2016.

    * RCC structure and brick work completed.
    * External plaster and finishes under progress.



    REVISION OF PAYMENT SCHEDULE

    1. Based on progress of construction, it has become necessary to revise the payment schedule and PDC of the above project.  The instalment of 10% cost of DU which is due on 15 Jun 2016 has been postponed as under:-

    (a) Allottees Whose  6th (10%) Instalment is Due for Payment on 15 Jun 2016.

    Instalment No

    Type of
    Payment

    Due Date
    For Read
    6 10% Cost of DU 15 Jun 2016 30 Nov 2016

    (b)  For Late Allottees Who are Not Covered Under Para 1(a) Above.

    Instalment No

    Type of
    Payment

    Due Date
    For Read
    5/4/3 10% Cost of DU     15 Jun 2016 30 Nov 2016

    2. There is no change in the amount of instalment and other terms and conditions.

    3. The PDC of the Project has also been revised from Nov 2016 to Jun 2017.

    4. Initial allottees who have already made lump sum payment as per Para 4 (a) of the Booking letter may ignore the communication regarding postponement of instalment.

    5. The inconvenience caused due to this unavoidable postponement is regretted.



    With reference to notice posted on 03 Jul 2015 regarding provisioning of grabage chutes, the majority view is against the same. Therefore, it has been decided not to provide garbage chutes in the project.


    ANNOUNCEMENT : CONSTRUCTION OF SCHOOLS AT AWHO PROJECT GURGAON SECTOR-95 AS MANDATED BY HUDA


    ROUTE TO AWHO SECTOR -95 SITE FROM DELHI (From Pataudi Road)

    ROUTE TO AWHO SECTOR -95 SITE FROM DELHI (From NH-8 )



  • General The complex is being constructed on a 24.53 acre plot. Turnkey project at Sector 95 Gurgaon.  The project is being  executed by a reputed builder who is also the owner of this land and has earlier developed a number of large residential projects in Ghaziabad and is also  constructing a number of projects in Gurgaon.

     Location The site is located in Sector- 95, Gurgaon and  is accessible by Pataudi Road on the North, 60m  proposed Master plan road on the South and 24m. proposed sector road on the East. Location is most sought after residential area in NCR due to its proximity to the Domestic and International Airports. The locality is fast developing with all civic amenities in vicinity. Surrounding areas are being developed for Housing.



    Concept The Housing Project  has been planned with a total of 1221 Dwelling Units of  different types such as Luxury, Super Deluxe, Deluxe and Small Family Apartments, to be constructed in 17 multi-storeyed towers with varying number of floor configurations of Stilt+7 to Stilt+23. Each tower consists of 4 DUs per floor and the DUs are designed for 2/3/4 BHK.
    All towers have Basements with sufficient area for parking of cars, with adequate space for movement. The Stilts shall also be utilized for parking. The clusters are placed in such a way that each DU gets sufficient natural ventilation and light. The scheme is planned to fulfill all the essential requirements of the occupants. Windows and openings are designed to give full privacy to each DU.  The entire layout of the project is designed to suit the shape of land. The blocks are placed in different interconnected pockets in such a way that each pocket gets large landscaped green areas, sufficient internal access and space for open surface parking.   Proper attention is being given for the provision of street lighting and external services.    Adequate parking space has been provided within the complex. A total of 1832 parking has been planned under stilt, basement and in the open area

    A separate pocket is planned to accommodate Economically Weaker Sections (EWS) of the society as mandated in the bye laws.



    Central Amenities

    •     A Club building along with open air Swimming Pool and other sports facilities will be provided. Club building is designed to accommodate RWA office, Banquet Hall, Restaurant, 2 Nos Squash Courts, Halls for indoor games viz. Billiards, Table Tennis, Card Room etc, Conference Hall, Library, Guest Rooms etc with sufficient Nos of Toilets. In addition, Children’s play area and 1 open Skating Rink will be provided.
    •     There is also a provision for 2 Nos open Tennis Courts, 4 Nos open Badminton Courts, and 2 Nos Basket Ball Courts. A small Shopping Complex is provided for daily needs.
    •     Luxury Apartments will have a separate open air Swimming Pool along with allied facilities.
    •    Security systems: CCTV surveillance cameras at exit/entry points of all towers.



    Eligibility

    Retired/Serving Army Personnel & their widows and also parents of unmarried fatal battle/ other casualty (if applied within five years of demise of their son/daughter) who are in receipt of family pension from CDA (P) Allahabad can apply.

    Owners/allottees & existing waitlisted registrants can also apply. However they will be considered as priority II.



    Probable Date of Completion

    PDC under revision.



    Contact Details

    Project Director
    Army Welfare Housing Organisation
    AWHO Complex, Sector-49, Southy City II
    Gurgaon-122002.


    Mob  : 9717770341; 9216912225

    (08.00 am to 05.00 pm)

    E-mail id : This email address is being protected from spambots. You need JavaScript enabled to view it.

  • Configuration & Cost

    S No

    Type of Dwelling  Unit

    Accommodation

    Approx Super Area  (Sq ft)

    Total No of DUs

    Approx Tentative Cost        (in Lacs) per DU

    1

    Small Family Apartment

    (SFA)

    Drawing/Dining, two Bed Rooms, two Toilets,  Kitchen and Balconies.

    900

    162

    Click here for Latest Costing

    2.

     Deluxe Apartment  (DXA)

    Drawing and Dining, two Bed Rooms, Study, two Toilets, Kitchen and Balconies

    1400

    300

    3.

    Super Deluxe Apartment  (SDA)

    Drawing and dining, Kitchen, Three Bed Rooms, three Toilets, one Dress, Store and Balconies.

    1750

    539

    4.

    Luxury Apartment  (LXA)

    Drawing and Dining, Kitchen, four Bed Rooms, three Toilets, one Dress, Store and Balconies.

    2150

    220

    Following types of DUs are being constructed :-


    Note : Cost of parking shall be extra.
